Skip to content
Drawing set CM-2026 · Digital portfolioRev A · 2026.10.09
Case study CS-02 · Process architecture / ServiceM8

Sales pipeline & customer journey restructure

EZPZ Mowing runs sales and customer care through ServiceM8 job queues. Christine rebuilt them as 17 queues, each defined by stage entry, next action, follow-up timing and exit rules, so the queue a job sits in describes the customer's progress. The major restructure went live on 11 February 2026 and has been refined since.

Business
EZPZ Mowing · Husqvarna Automower specialist
Platform
ServiceM8 job queues
Queues
17 · 12 sales, 3 exit, 2 customer care
Restructure
11 Feb 2026 · refined since
Documented
08 Oct 2026, current workflow (E-01)
Drawing set
CM-2026-CS02 · 4 sheets · 9 evidence items
CS02.B1 Sales pipeline · simplified from E-01Queues numbered as in ServiceM8
  1. STAGE 01 · QUEUES 01–04Make contactNew Lead · 1st, 2nd, 3rd Attempt. Same-day first call, then one day apart.G1 · ENGAGED → 05
  2. STAGE 02 · QUEUES 05–06Pre-consult pricingPCP in Progress · PCP Sent – FF Up. Draft mapping, initial recommendation, high-level pricing.G2 · PCP ACCEPTED → 07
  3. STAGE 03 · QUEUES 07–10Personalised proposalBooked Consult · Quote in Progress · Quote Sent – FF Up · Negotiation.G3 · ≥ 1,500 m² → SITE VISIT · G4 → 11
  4. STAGE 04 · QUEUES 11–12Acceptance + installInvoicing · Closed Won. Order equipment, schedule installation, record install date.G5 · FUNDS RECEIVED → 12
EXIT · 13–15
Closed Lost · Lost No Answer (after 4 calls) · Nurture (re-engagement to an active stage)
CUSTOMER CARE · 16–17
Warranty / Repair · Annual Service Due, 12 months after install
1.0 — Context & problem

Queues that described activity, not progress

The previous queue set (E-02) mixed customer progress with communication activity, such as a “Sent email” queue, and grouped undecided, deferred and negotiating leads together.

Objective

Define every queue by stage entry, next action, follow-up timing and exit rules, so the queue a job sits in describes the customer's progress.

E-02 · Previous queue → current stage
Previous queueCurrent stage / routeWhat changed
Contact made – Automower01 → 02 → 03 → 04Same-day first call; attempts one day apart. After 4 unanswered calls → 14 Lost No Answer.
Need to Quote05 PCP in Progress · 08 Quote in ProgressInitial mapping and high-level pricing separated from the personalised proposal.
Quoted – Customer Undecided09 · 10 Negotiation · 15 NurtureUndecided leads separated by engagement.
Accepted11 Invoicing → 12 Closed WonPaid jobs move to Closed Won.
Jobs to do in the future15 Nurture · 12 Closed WonFuture interest distinguished from work already sold. Service tracked in 16 and 17.
Automower quotes to follow up on06 · 09 · 10Separate cadences: PCP Days 1/4/10; proposal Days 1/4/10/21; negotiation every 4 days.
Sent emailStage matching the email's purposeEmail is logged as an activity on the job; the queue describes customer progress.
2.0 — Christine's responsibilities

Responsibility matrix

Performed
  • Pipeline stage architecture (17 queues)
  • Entry, progression and exit rules
  • Follow-up cadences
  • Legacy queue mapping guide (E-02)
  • Stage communication templates
  • ServiceM8 queue configuration
  • ServiceM8 cadence automation (queue 09)
  • Daily queue operation and customer contact
EZPZ team / technician
  • Workflow approval (business owner)
  • Installation delivery
3.0 — Technical approach & key decisions

Decision rules & cadences

  1. 4 callsStill unreachable after the fourth call → 14 Lost No Answer.
  2. 1,500 m²Lawn area at or above → site visit. Below → photos of lawn and outdoor power points.
  3. Day 10 / 21No response after the PCP or proposal cadence → 15 Nurture.
  4. 30 daysNegotiation without response → 15 Nurture. Timing resets on each response.
Follow-up cadences · days from stage entry · E-01
QueueCadenceExitMode
01–04 Contact attemptsCall, then 1 day apart ×4→ 14 after 4 callsMANUAL · CHRISTINE
06 PCP Sent – FF UpDays 1 / 4 / 10→ 15 NurtureMANUAL · CHRISTINE
09 Quote Sent – FF UpDays 1 / 4 / 10 / 21→ 15 NurtureAUTOMATED · SERVICEM8
10 NegotiationEvery 4 days from latest response→ 15 at 30 daysMANUAL · CHRISTINE

Mapping rule for migration: a job's current stage is chosen from its history and the latest customer response, not from the old queue label alone.

4.0 — Verified outputs & results

Live in ServiceM8

  • Major pipeline restructure implemented in ServiceM8 on 11 February 2026, then extended through later refinements to the current 17 queues (E-06).
  • Every queue defined by stage entry, next action, follow-up timing and exit rules (E-01).
  • Legacy queue labels mapped to current stages (E-02).
  • Proposal follow-up sequence automated in ServiceM8; stage templates in use on live jobs, June to October 2026 (E-03 – E-09).

The dates of individual refinements after 11 February are not recorded. PCP and proposal content is covered in CS-03.

5.0 — Tools & systems used

ServiceM8 job queues ServiceM8 automation ServiceM8 job diary SMS + email templates

Capability demonstrated

C1
Process architecture: 17-queue stage model, configured
C2
Decision rules with explicit thresholds
C3
Four cadences; proposal sequence automated
C4
Change migration from legacy queues
C5
Stage templates with a clear next step
6.0 — Evidence

Templates in operation

Customer identity, contact and staff names redacted · select an item to read it in full
ServiceM8 queue toolbar showing the pipeline queues in order from New Lead to Annual Servicing; live job counts redacted
E-06ServiceM8 queue configuration, 08 Oct 2026, configured by Christine. Live job counts redacted; Demo Day is an ad hoc events queue outside the sales pipeline.

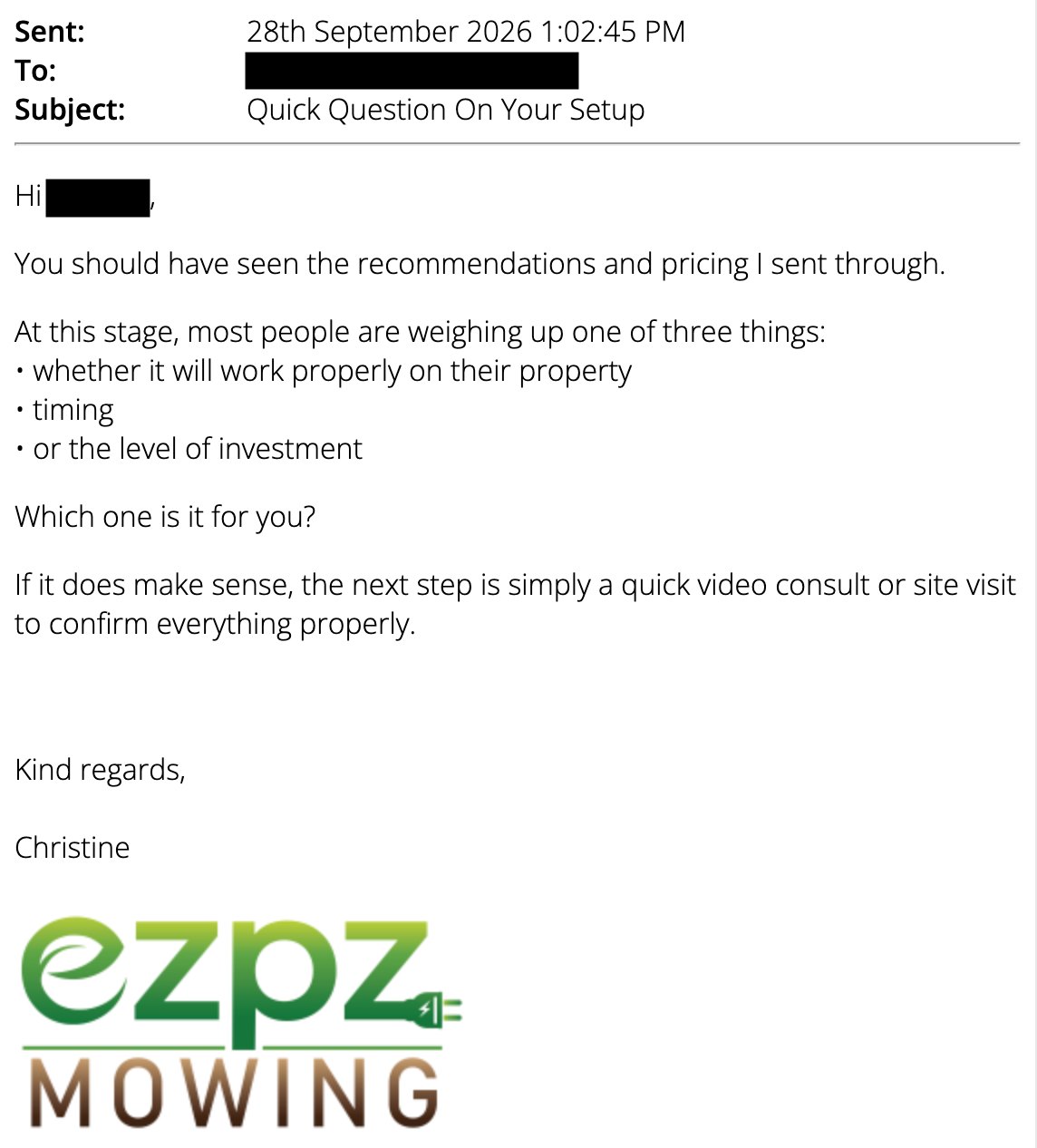

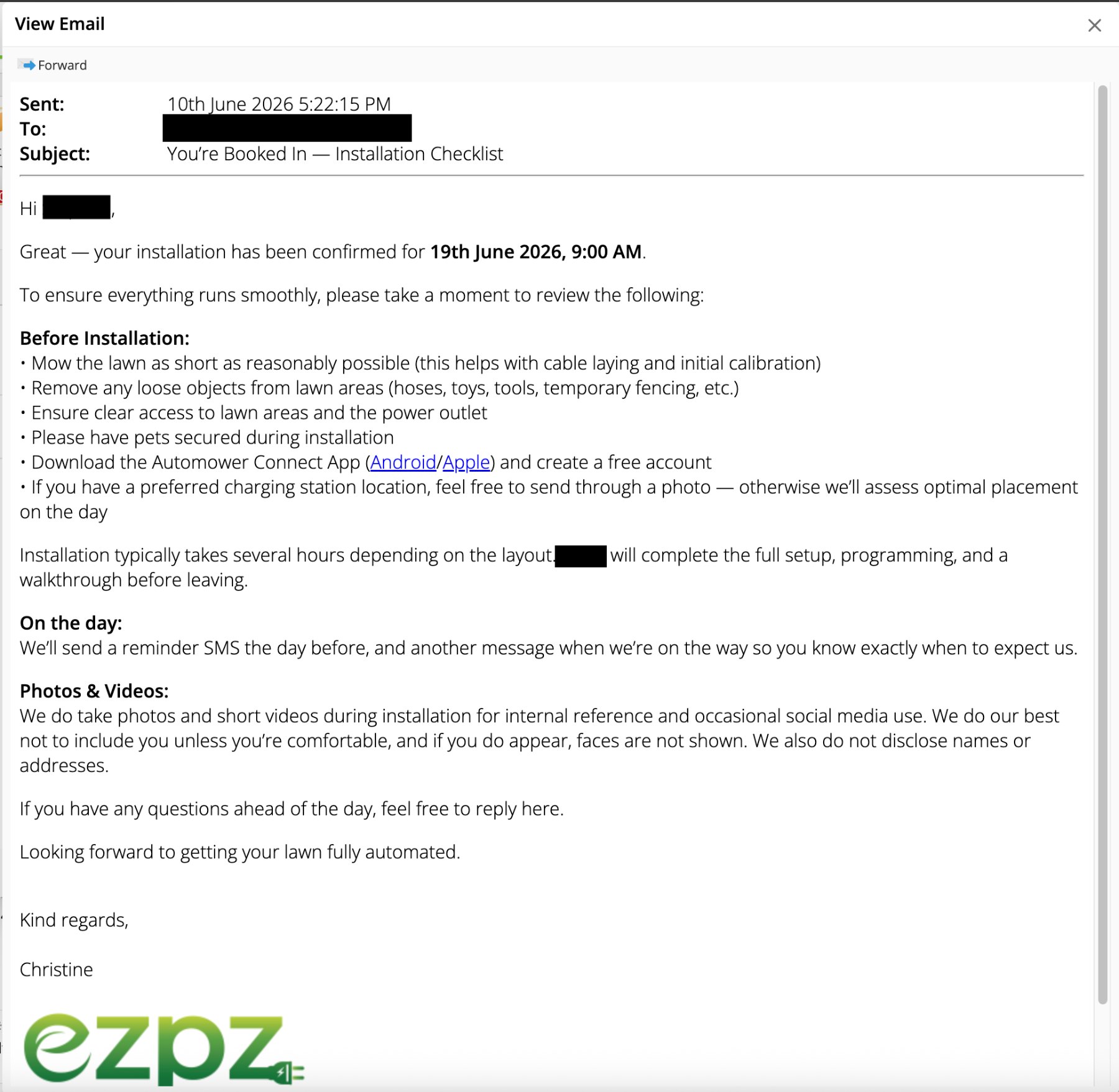

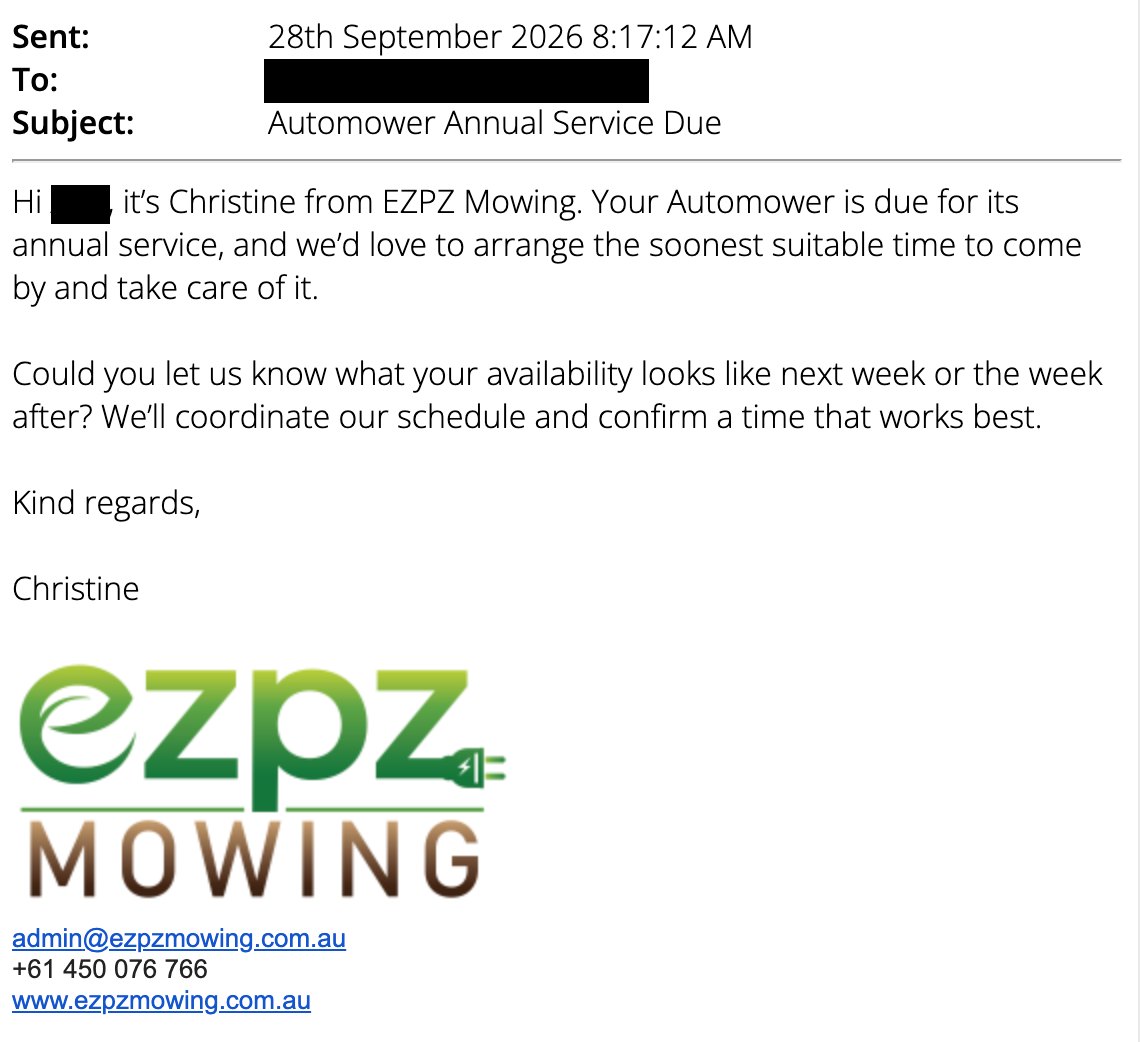

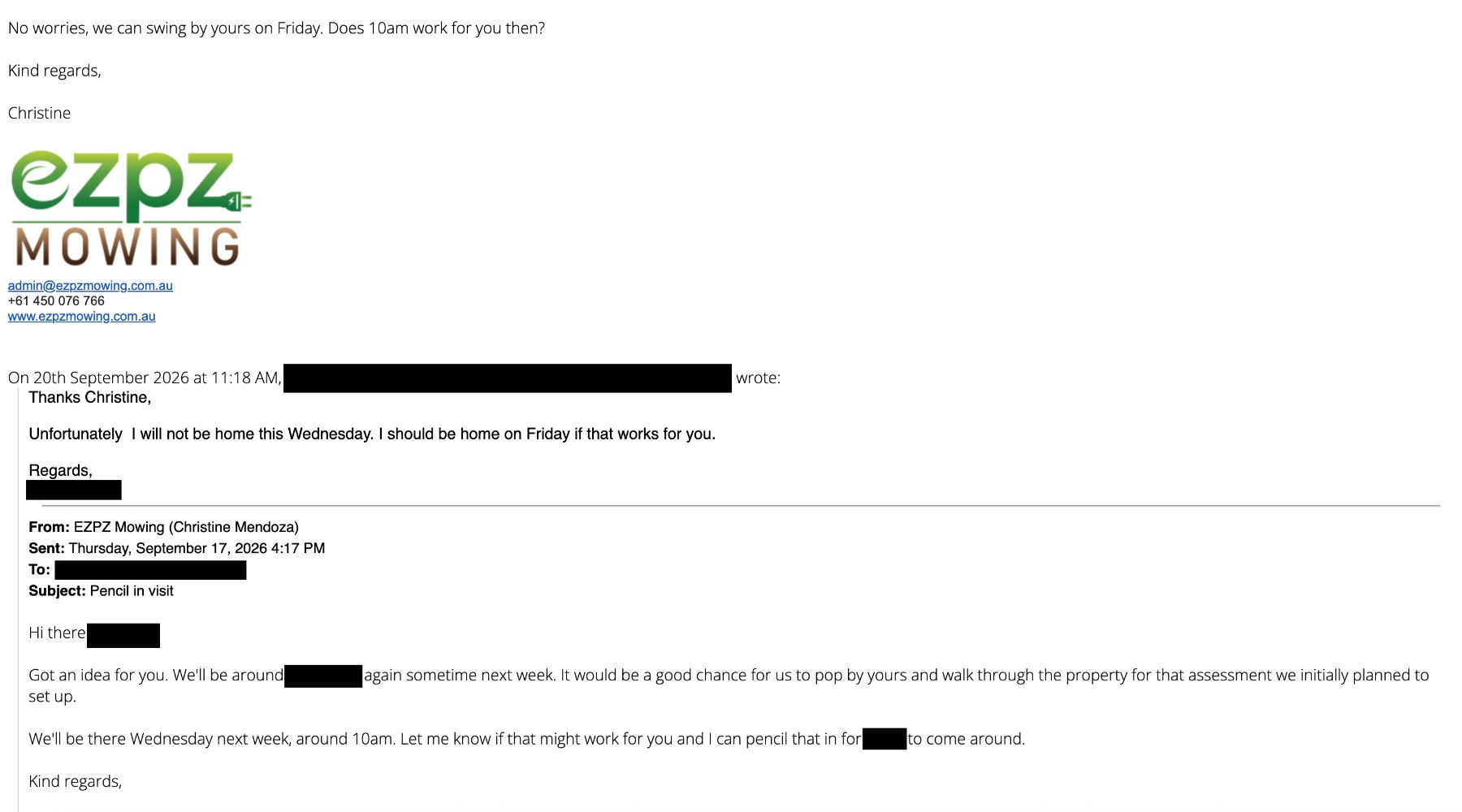

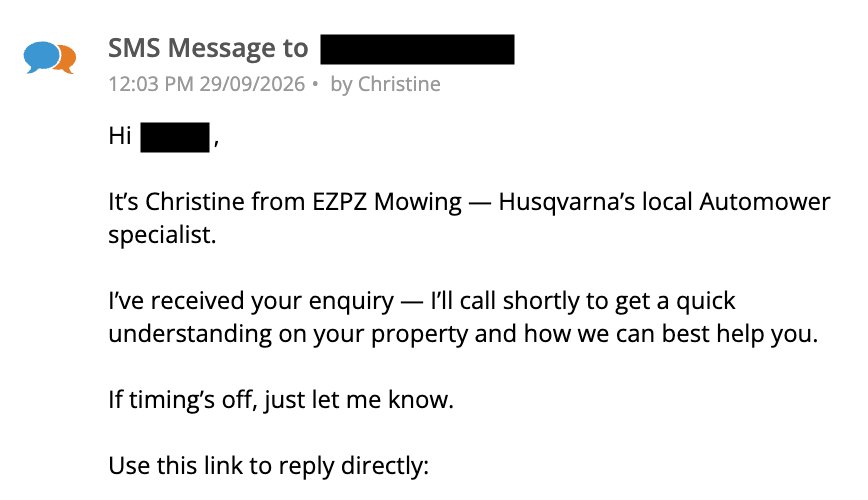

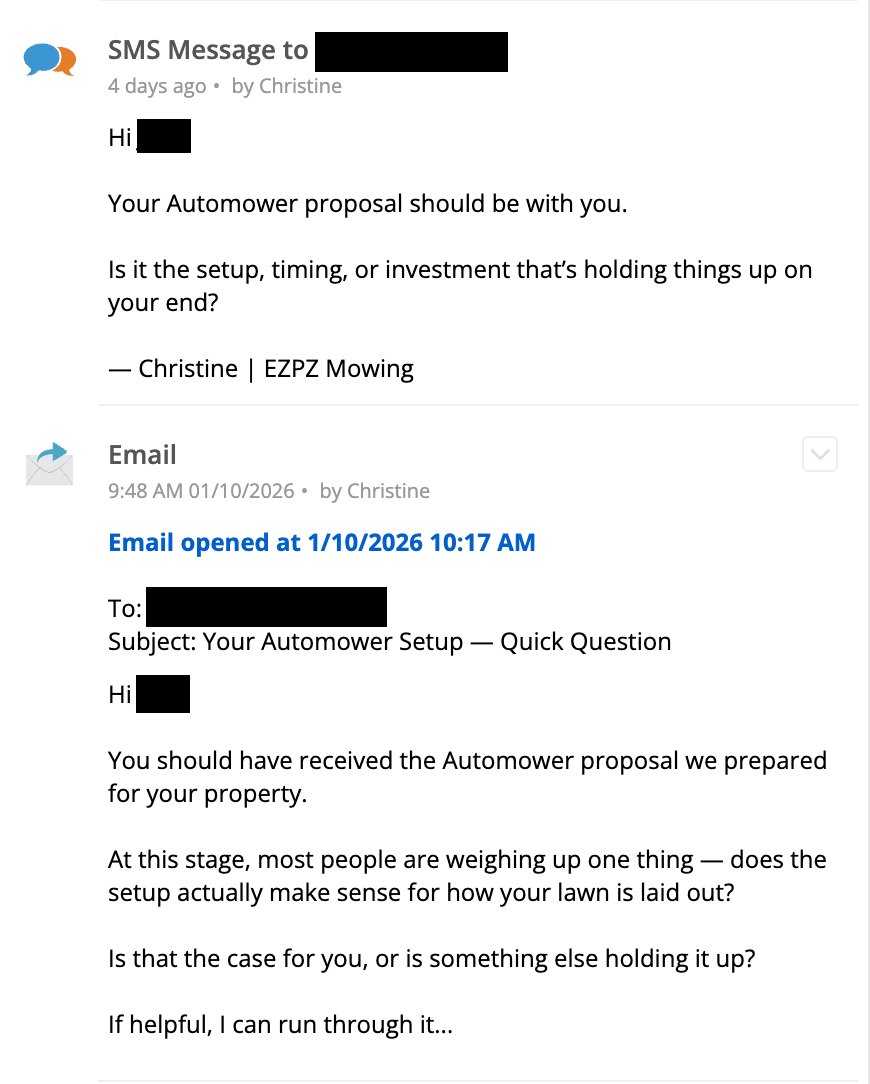

SMS · 29 Sep 2026 · Stage 01First-contact SMSRedacted · Customer name, contactE-03 · SMSOpen evidence ⤢Sent before the first call: identifies Christine and EZPZ, confirms the enquiry, says a call is coming and offers a reply link. Email · 28 Sep 2026 · Stage 06Quick Question On Your SetupRedacted · Customer name, emailE-04 · EmailOpen evidence ⤢PCP follow-up: names the three decision factors (fit, timing, investment), asks which applies and routes to a consult or site visit. Email thread · Sep 2026 · Stage 07Pencil in visitRedacted · Customer, location, staffE-07 · EmailOpen evidence ⤢Site-visit coordination: a visit proposed for a day the team is in the area, then rescheduled to suit the customer. SMS + email · 01 Oct 2026 · Stage 09Proposal follow-upRedacted · Customer name, contactE-08 · SMS + emailOpen evidence ⤢Automated ServiceM8 sequence after the proposal: an SMS and an email that ask what is holding the decision up. Email · 10 Jun 2026 · Stage 12You’re Booked In — Installation ChecklistRedacted · Customer name, technicianE-05 · EmailOpen evidence ⤢Confirms date and time, lists pre-install preparation, states the technician’s role, day-of messages and photo consent. Email · 28 Sep 2026 · Stage 17Automower Annual Service DueRedacted · Customer name, emailE-09 · EmailOpen evidence ⤢Annual-service contact after the internal reminder: asks for availability over the next two weeks.
7.0 — Full technical drawing set

CM-2026-CS02 · four A3 sheets

The complete, original case study, including the full process-flow drawing and communication register. Opens full screen in a new tab; best viewed on a larger display.

Open full technical drawing set
  1. ASystem overview / role / evidence index
  2. BPipeline process flow
  3. CCadences / communication register
  4. DImplementation / capability
